Transparent, factual reporting on the 2026 School Bond — tracking construction progress, timelines, and community investment across five campuses.

Our community has the opportunity to support long-term investments in our schools through the 2026 School Bond. This page provides clear, factual information about the proposed bond measure, including how school bonds work, planned projects, estimated tax impact, and frequently asked questions. We encourage families, staff, and community members to review the information below and stay informed.

Phase 3 — Campus & Athletic Improvements

Active Construction Projects

All Phase 3 projects are funded through the 2026 bond.

IDEA Weslaco Phase 3

Campus & Athletic Improvements
26761  sq ft
high school classroom building

Completion:

June 2027

Construction is scheduled to begin on the IDEA Weslaco Phase 3 project in May 2026. This project includes the construction of a new 26,761-square-foot building with high school classrooms, support offices, and a gymnasium.

Planned improvements also include interior and exterior painting, HVAC equipment replacements, parking and driveway resurfacing, and enhanced landscaping. Site upgrades will add new sidewalks, exterior lighting, playground equipment, and a new soccer field with bleacher seating.

These upgrades will support growing student enrollment and provide expanded spaces for academic and extracurricular programs. Construction is expected to continue through June 2027

IDEA Pharr Phase 3

Campus & Athletic Improvements
25748  sq ft
high school classroom building

Completion:

June 2027

Construction is scheduled to begin on the IDEA Pharr Phase 3 project in May 2026. This project includes the construction of a new 25,748-square-foot building with high school classrooms, support offices, and a gymnasium.

Planned improvements also include interior and exterior painting, HVAC equipment replacements, parking and driveway resurfacing, and enhanced landscaping. Site upgrades will add new sidewalks, exterior lighting, playground equipment, and a new soccer field with bleacher seating.

This project will create a dedicated high school learning environment while strengthening athletic and student activity programs. Construction is expected to continue through June 2027.

IDEA Brownsville Phase 3

Campus & Athletic Improvements
26292  sq ft
gymnasium & classroom expansion

Completion:

June 2027

Construction is scheduled to begin on the IDEA Brownsville Phase 3 project in May 2026. This project includes the construction of a new 26,292-square-foot gymnasium and classroom wing, along with interior and exterior improvements across the campus.

Planned interior upgrades include classroom renovations, interior painting, and HVAC system improvements. Exterior work will focus on improving parking areas, landscaping, and the development of a competition soccer field with a jogging trail and sports lighting.

These improvements will expand athletic programming and provide students with upgraded classrooms designed to support college readiness and long-term success. Construction is expected to continue through June 2027.

IDEA North Mission Phase 3

Campus & Athletic Improvements
12953  sq ft
gymnasium & classroom expansion

Completion:

August 2027

Construction is scheduled to begin on the new gymnasium and campus improvements at IDEA North Mission in June 2026. This phase will include the development of a 12,953-square-foot gym, classroom renovations, HVAC upgrades, and interior painting.

Exterior work will include improvements to parking areas, landscaping, and the construction of a competition soccer field with a jogging trail and sports lighting.

These updates will strengthen athletic programming and enhance daily learning environments for students across grade levels. Construction is expected to continue through August 2027.

IDEA McAllen Phase 3

Campus & Athletic Improvements
— Largest Phase 3 Expansion
29988  sq ft
gymnasium & classroom expansion

Completion:

August 2027

Construction is scheduled to begin on the IDEA McAllen Phase 3 expansion in June 2026. This project will include the construction of a new 29,988-square-foot gymnasium and classroom wing, along with interior and exterior improvements across the campus.

Planned interior upgrades include classroom renovations, interior painting, and HVAC system improvements. Exterior work will focus on improving parking areas, landscaping, and the development of a competition soccer field with a jogging trail and sports lighting.

As one of the district’s largest Phase 3 projects, this expansion will significantly increase space for both academic instruction and competitive athletics. Construction is expected to continue through August 2027.

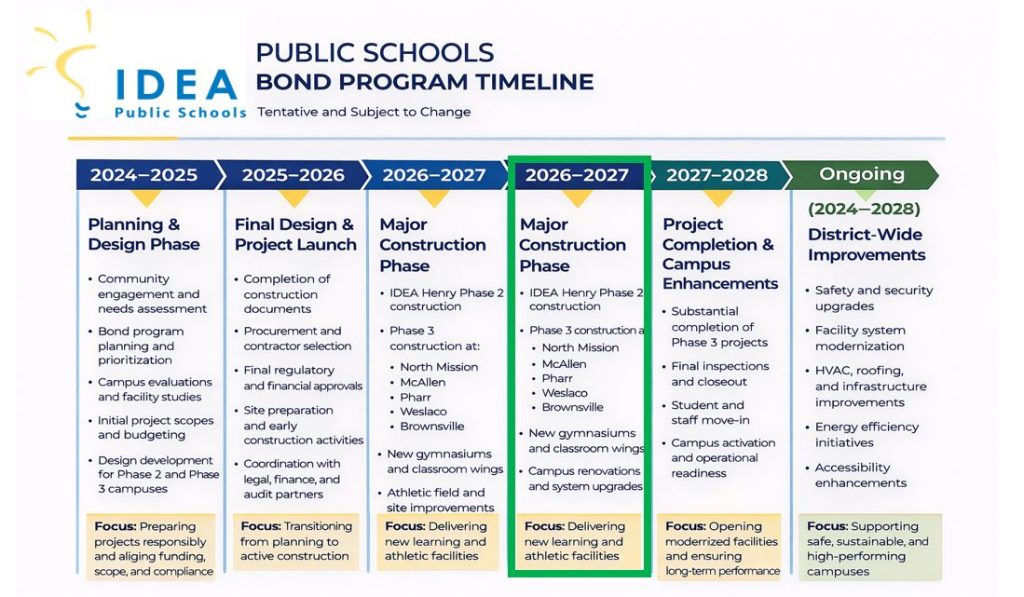

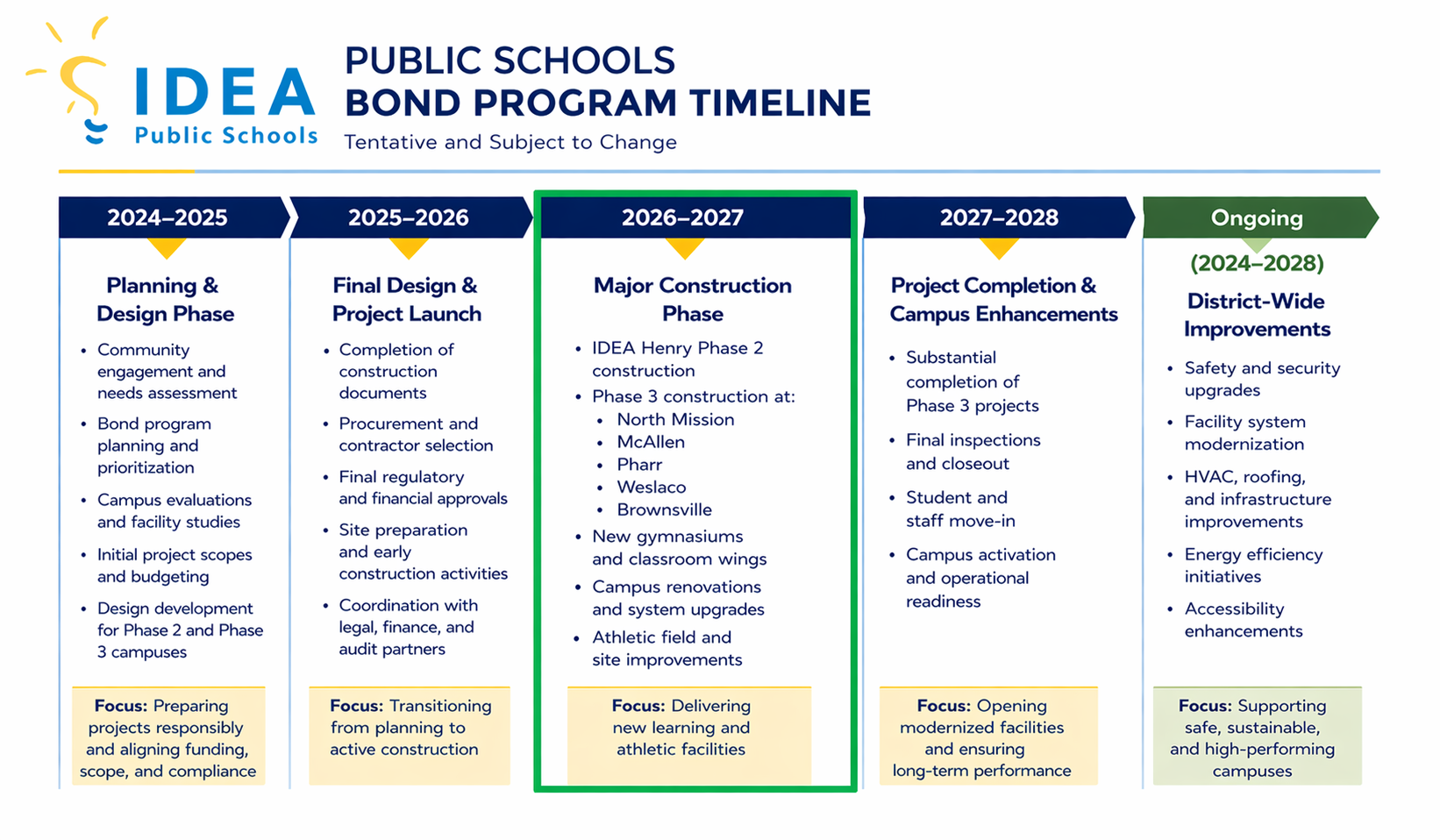

Bond Program Timeline

Construction at a Glance

IDEA Public Schools is committed to delivering bond-funded projects on time, on budget, and with transparency.

IDEA Henry Phase 1

Midland, Texas

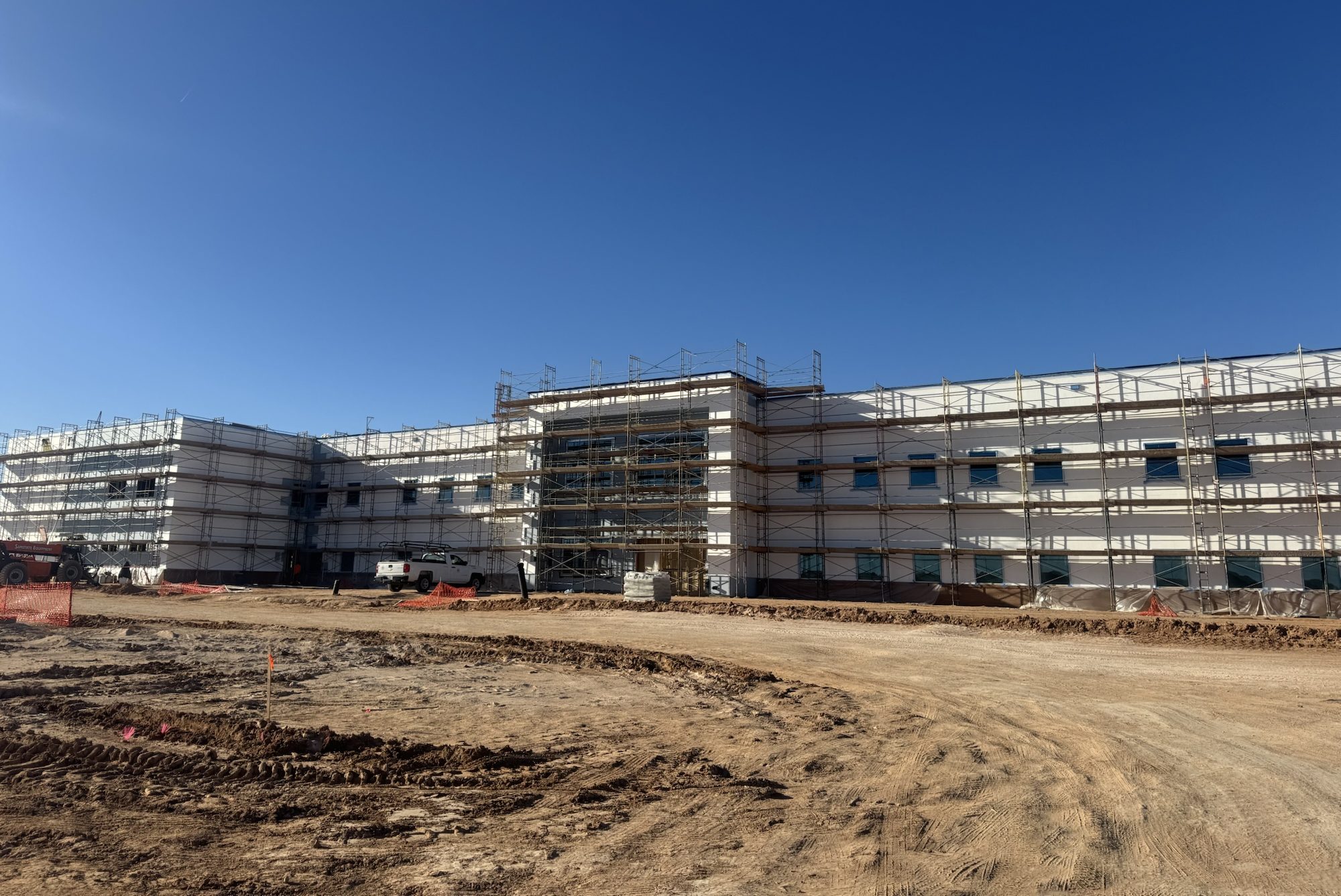

IDEA Henry construction progress, Fall 2025

Project Overview
IDEA Henry Phase 1 is a new two-story campus serving families in the Permian Basin, adding approximately 80,000 sq ft of instructional and student support space. The campus includes high school classrooms, administrative offices, and student spaces, with full site infrastructure: utilities, paving, landscaping, irrigation, and safety systems.

Current Progress
Construction began April 2025 and is on schedule. Crews are actively working on structural systems, building enclosure, and interior finishes including mechanical, electrical, and fire protection.

Community Impact
This $32 million investment will provide Midland students with a learning environment that supports college readiness and career pathways.

Total Investment

$32M

Stories

2 Floors

Status

Expected Opening

Fall 2026

IDEA Henry construction progress, Fall 2025
